Renovation Week 7: June 28 - July 2

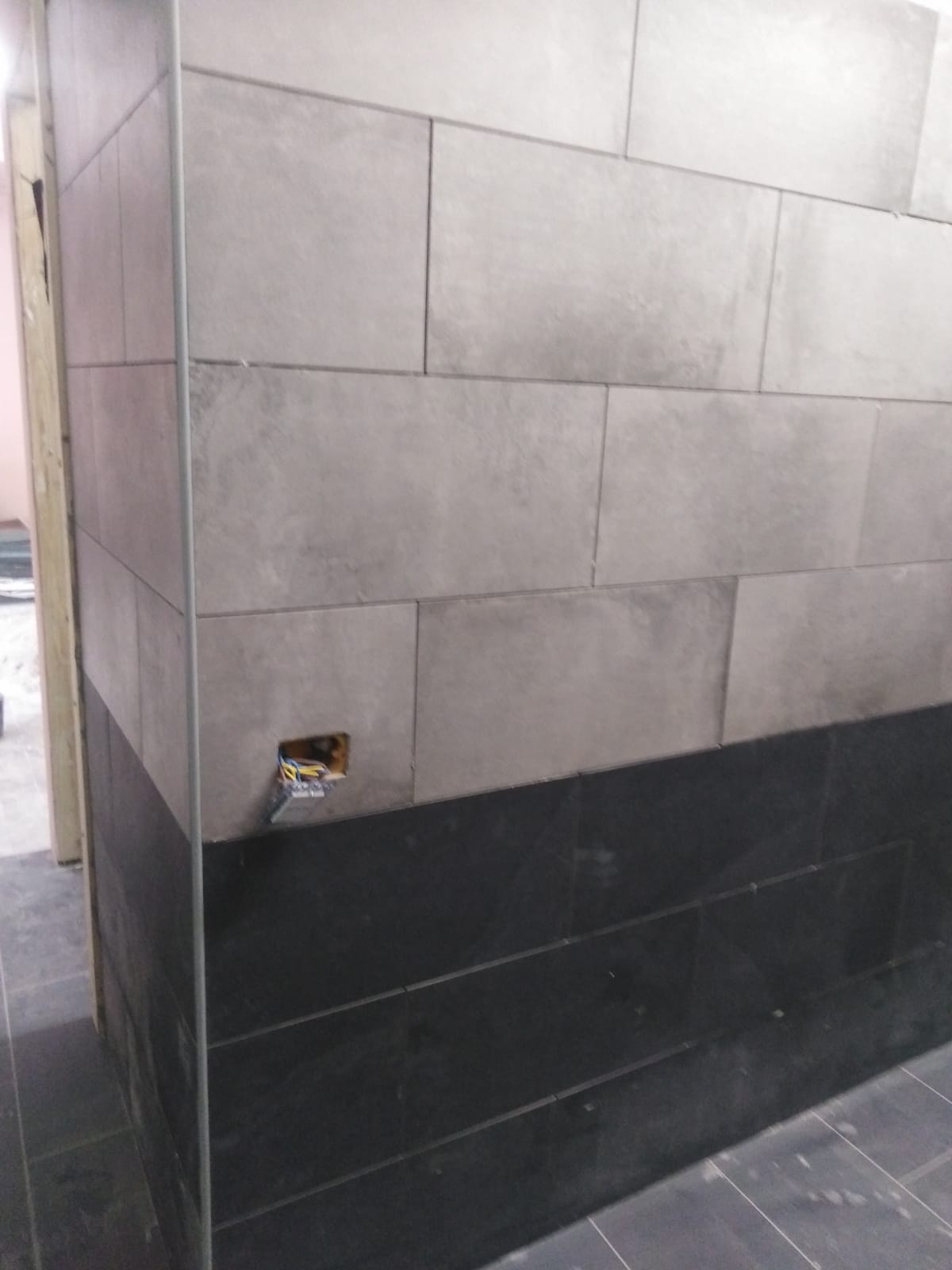

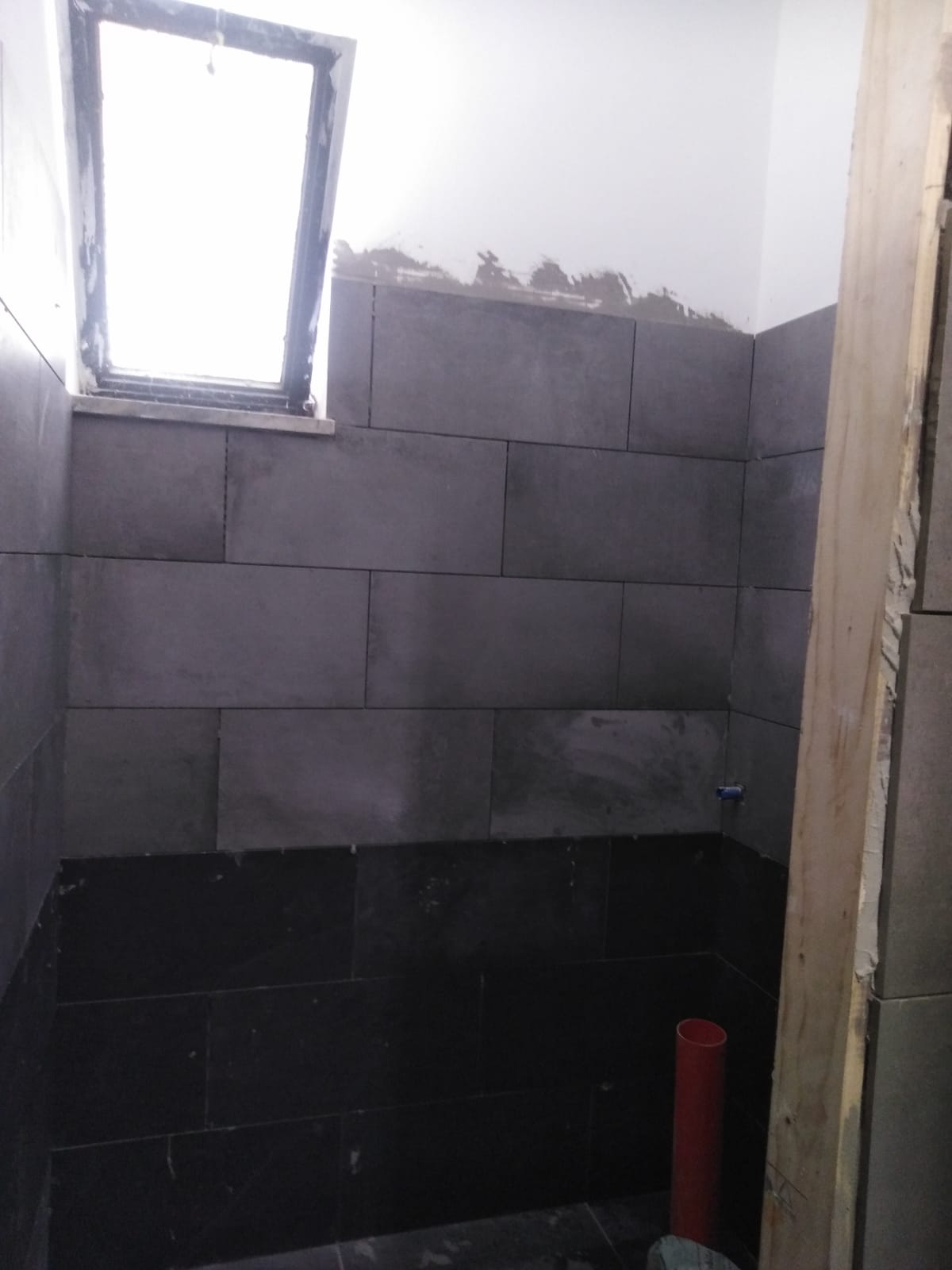

This week is left to the tile setter to finish up his work with the change room and bathroom tiles. Although these two rooms have a total floor surface of less than 20 square meters, with the walls the tile coverage increases to about 100 square meters.
Part of the change room wall is made from dry wall or sheetrock, so even with the green type, for a humid environment the tiles are necessary.

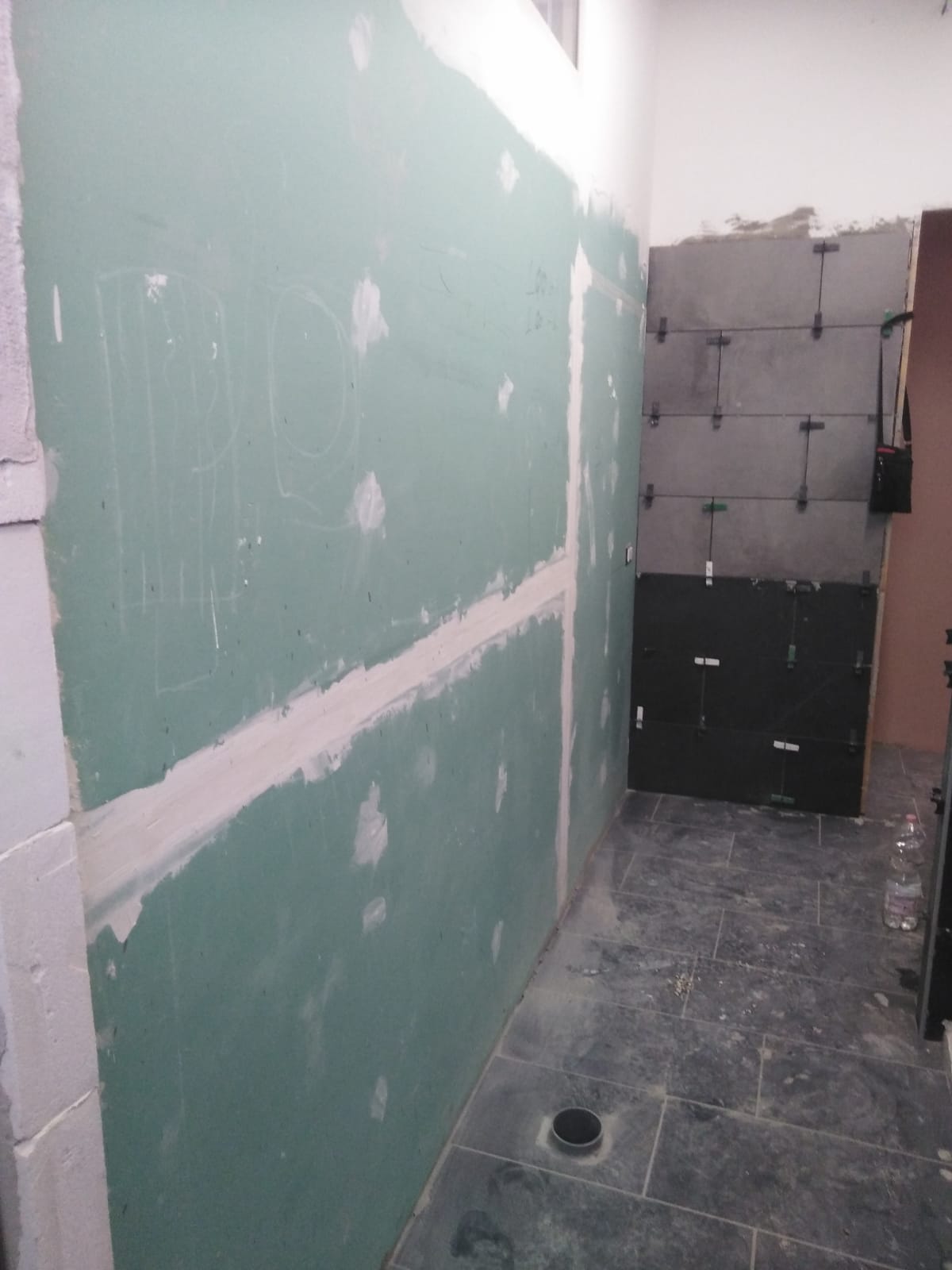

Change room partition wall has one wall made of dry wall
Next week the painters will return to do some touch-up work, while the electrician will finish installing ground wires, video camera ethernet cable, and finish up with the rest of the work. The pastor will return to finish up minor details such as decorative window framing, installing sanitary products such as sinks, toilets, bidet, shower head, faucets, shower hooks, etc.
