Renovation Week 4: June 7 - 11th

At the beginning of this renovation project, I thought we would be done with all the work at this point, but there is still much work to be done, and by the end of this week we would be more than 70% to the finish line. The focus of this week is on completing the plumbing for the change rooms and bathrooms as much as possible. The plumber, who is a pastor, is the best competent person on the team with a wealthy of experience and wisdom in construction and beyond.

At his recommendation, to accomodate and control the water flow to 4 sinks, 4 showers, 2 toilets, 1 bidet and 1 possible washing machine, the best choice is to centralize the valves.

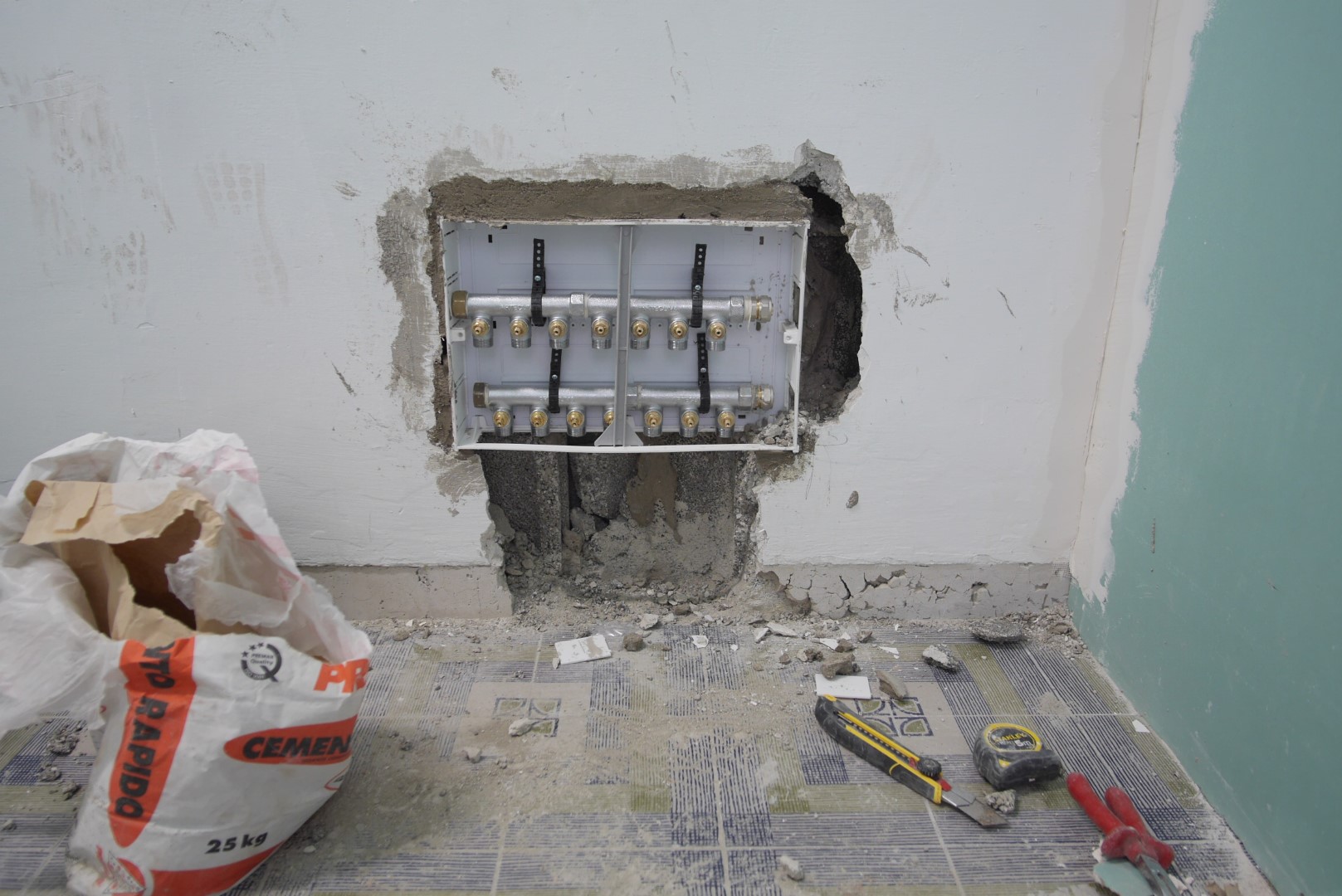

Centralized plumbing valves
Centralized water valve control, using top-quality Italian product

All the sanitary products were removed from the original bathroom, and the plumber created a new design for the junctions to allow more sources to discharge into the waste water pipe.

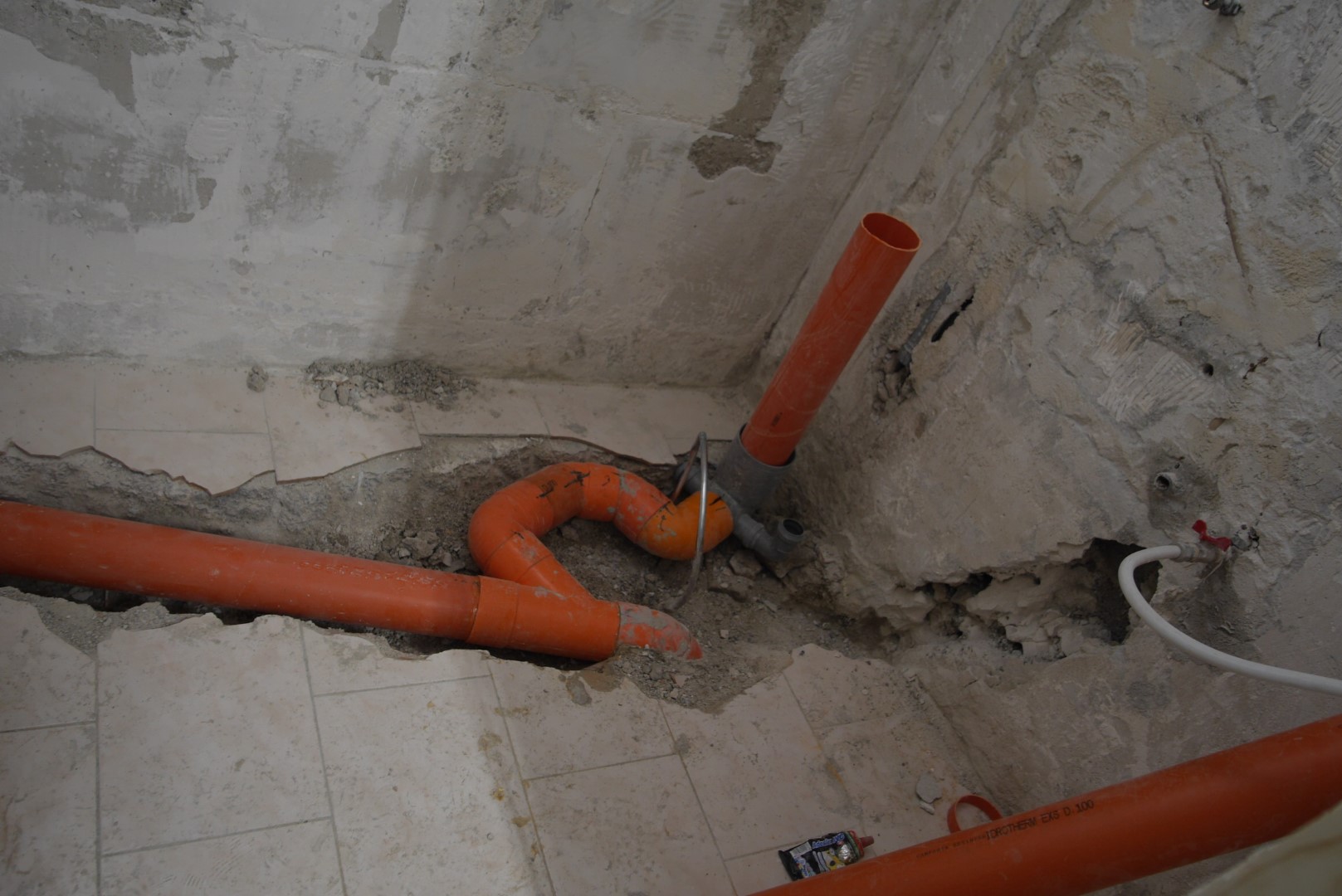

Original sewer pipe modified with new design  New change room water tubes and plumbing
Original sewer pipe modified with new design allowing other discharge sources to be connected (left)

New change room water tubes and plumbing (right)

Earlier during the project, when attempting to locate the sewer pipe, the plumber hit a reinforced concrete piece and accidentally broke the clean water tube. Some water leaked to the garage of a neighor who keeps a classic Jaguar in it. It caused a big argument between the neighbor and my workers. Fortunately no damage occurred. I relied on the original engineer's informal survey and thought that we would not have to deal with anyone's garage to do our work to re-route the pipes. Unfortunately a small section is in the corner of that garage.

To avoid future problems, and to improve water pressure. The plumber decided to close off the pipe carrying water to my unit and re-route it from another water piple outside that garage in a public area easy to access.

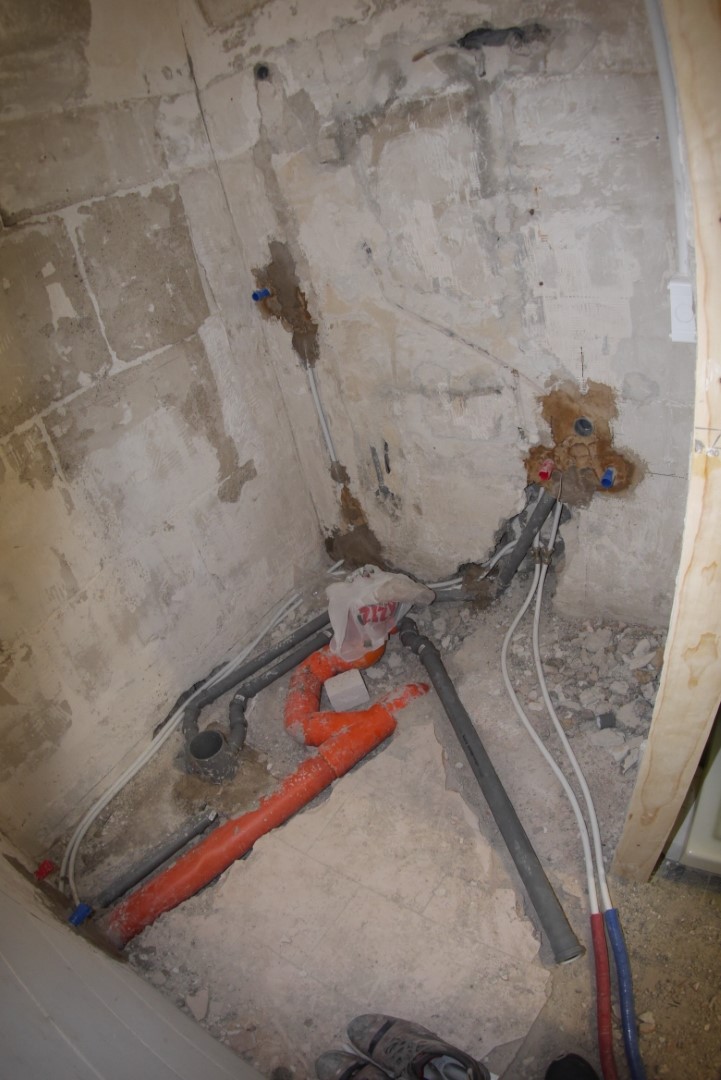

Old bathroom new sewer pipe design
Original bathroom with new waste water tube design. The bridge steel pipe is made to fix a broke clean water pipe.

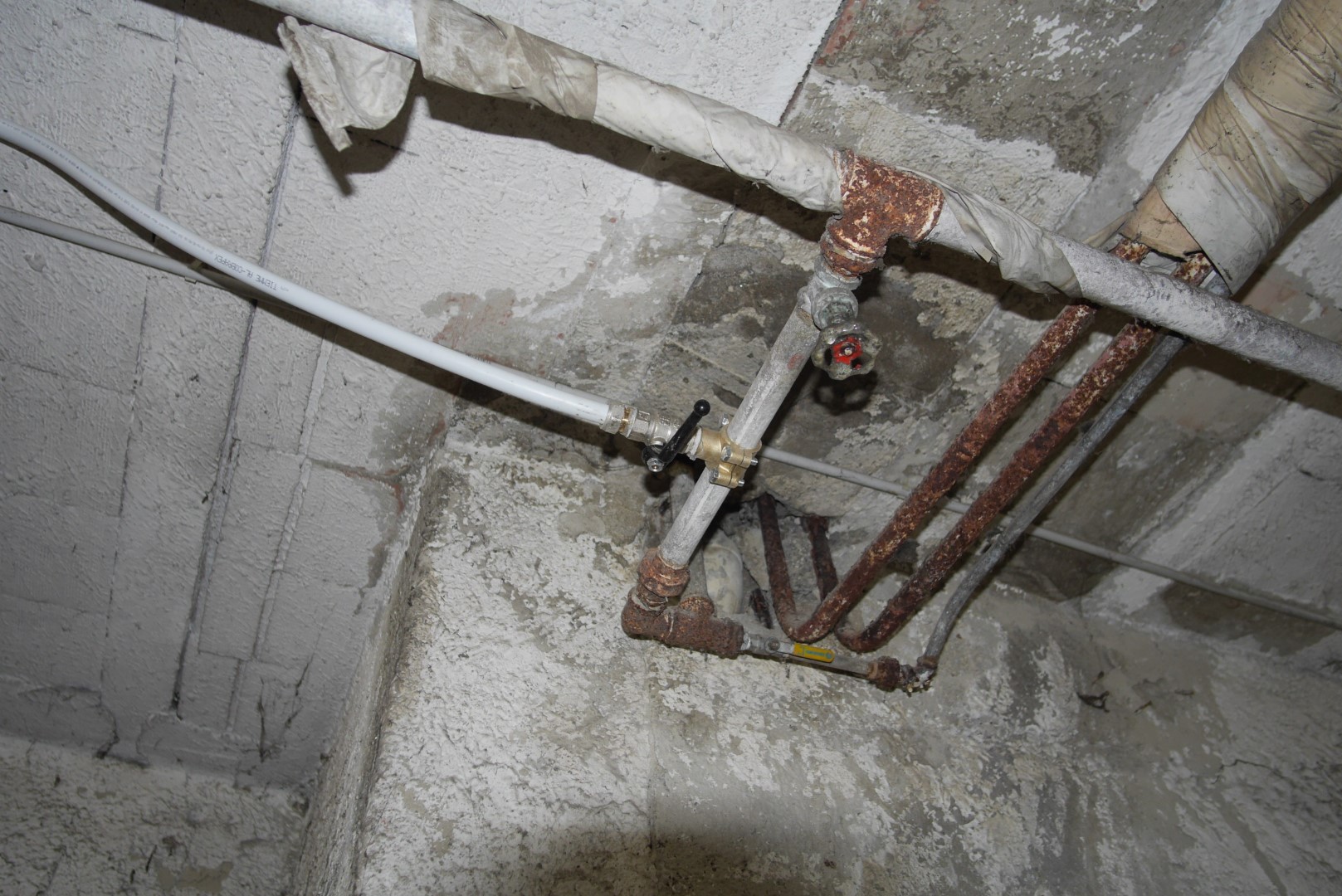

View of pipe from garage's public area below
View of pipe from garage's public area below. A new PVC pipe is installed to a tap with its independent control so I can always control our own water supply.

The plumbing of this building is a bit of a mess as it was constructed in the 1970s. The newly installed PVC tube comes a long way from the source and directly into our space above.

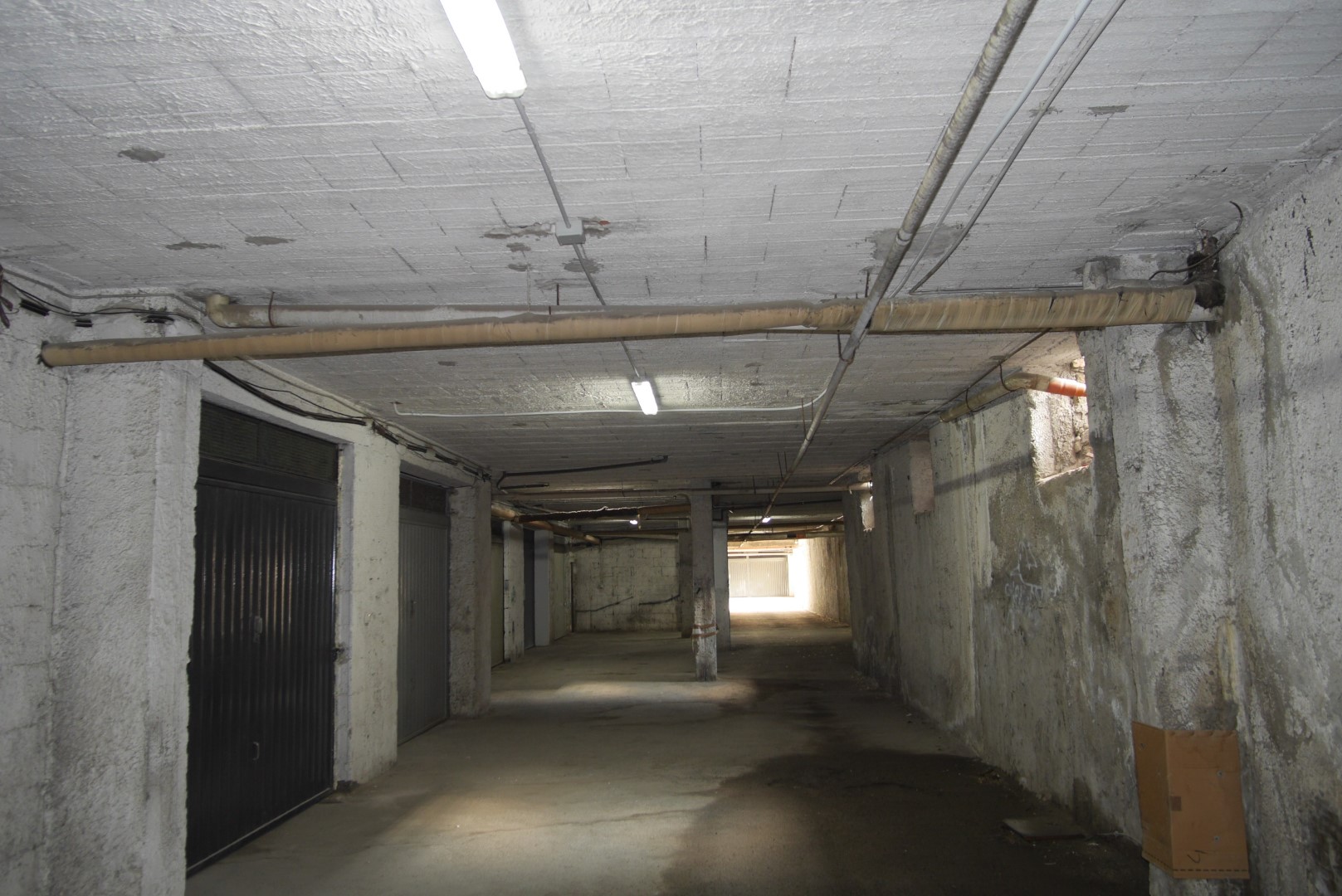

Pipes in garage
A view of the tubes for water and electrical system from the garage below

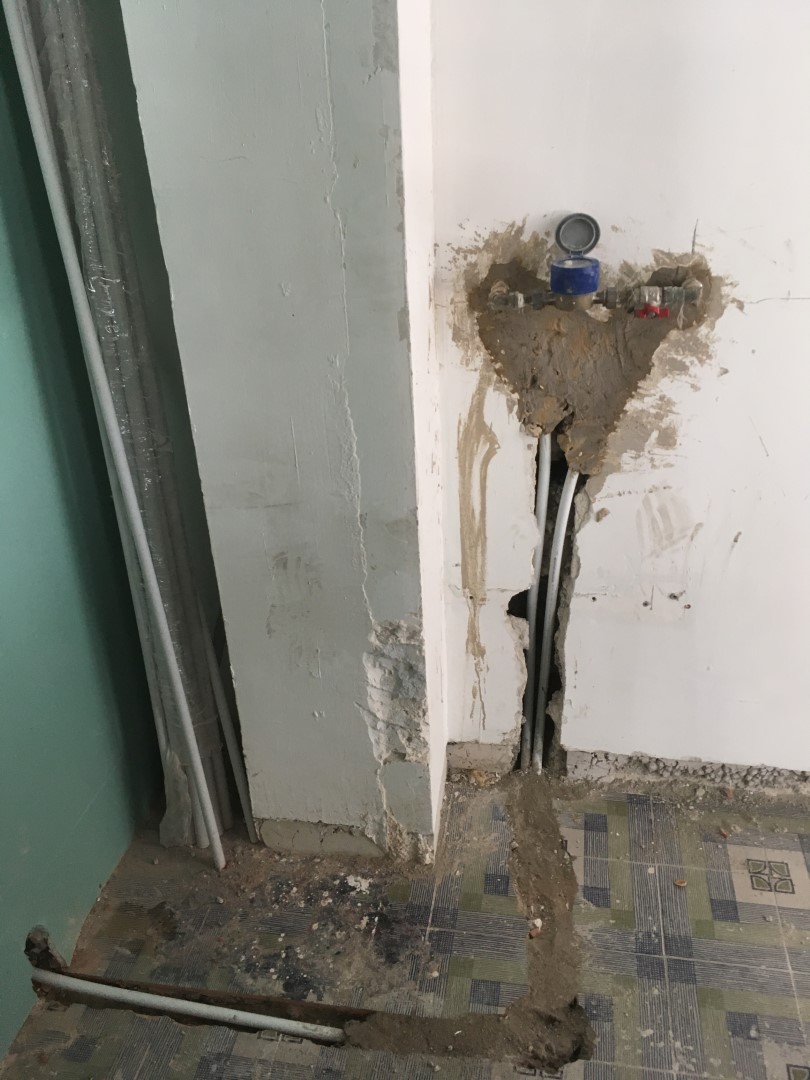

 Main water line from beneath  Main water line from beneath
New main water line location from beneath. Now it has also more water pressure to feed the additional equipment.

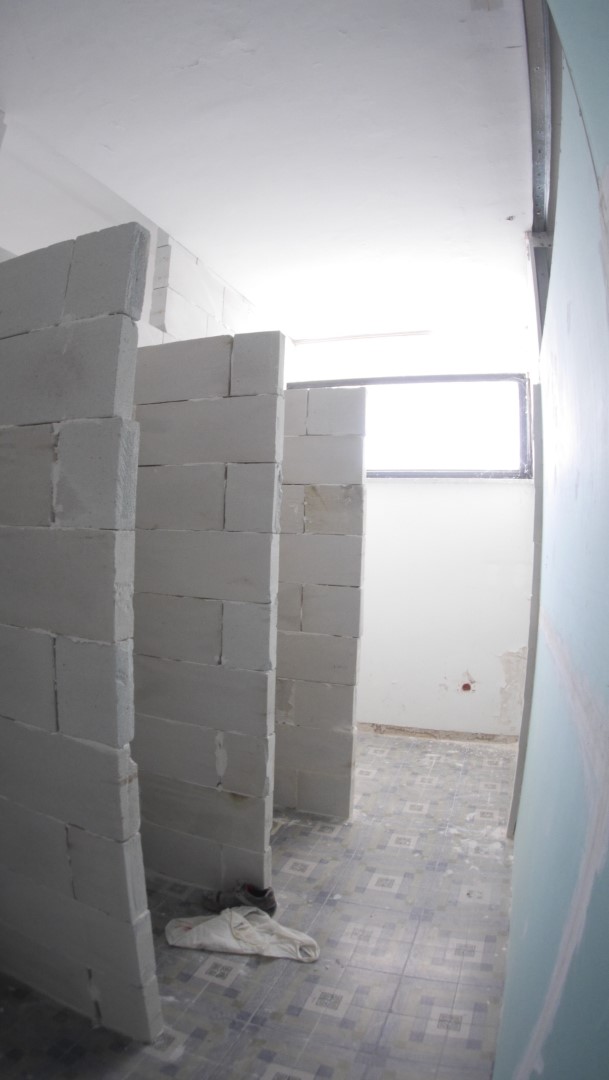

Making the secondard window entrance narrower

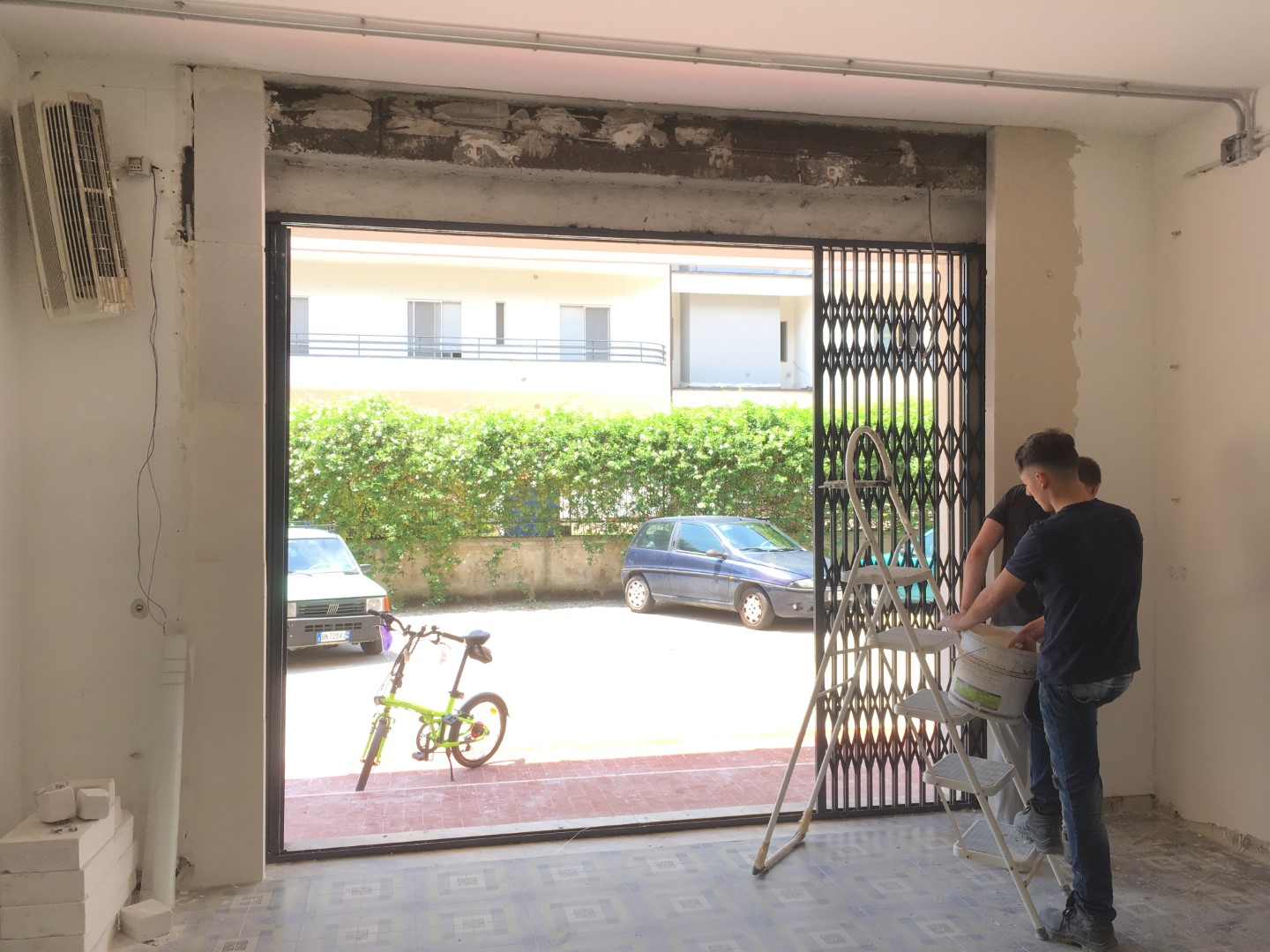

Making the secondard window entrance narrower to fit a new aluminum door and window frame better

To have a better fitting, view and save a bit of money. I asked the assistant brick layers to use Siporex to make the two sides of the secondary opening a bit narrower (about 40cm reduction on each side).

Plumbing for the new smaller change room
Plumbing for the new change rooms and bathrooms

By the end of week three, the main structures are already in place and the basic physical layout for the electrical wires are set. Week four will bring more serious plumbing work to route the pipes in their designated places. For the walls, the workers will begin putting stucco on mesh net and making other refinement.

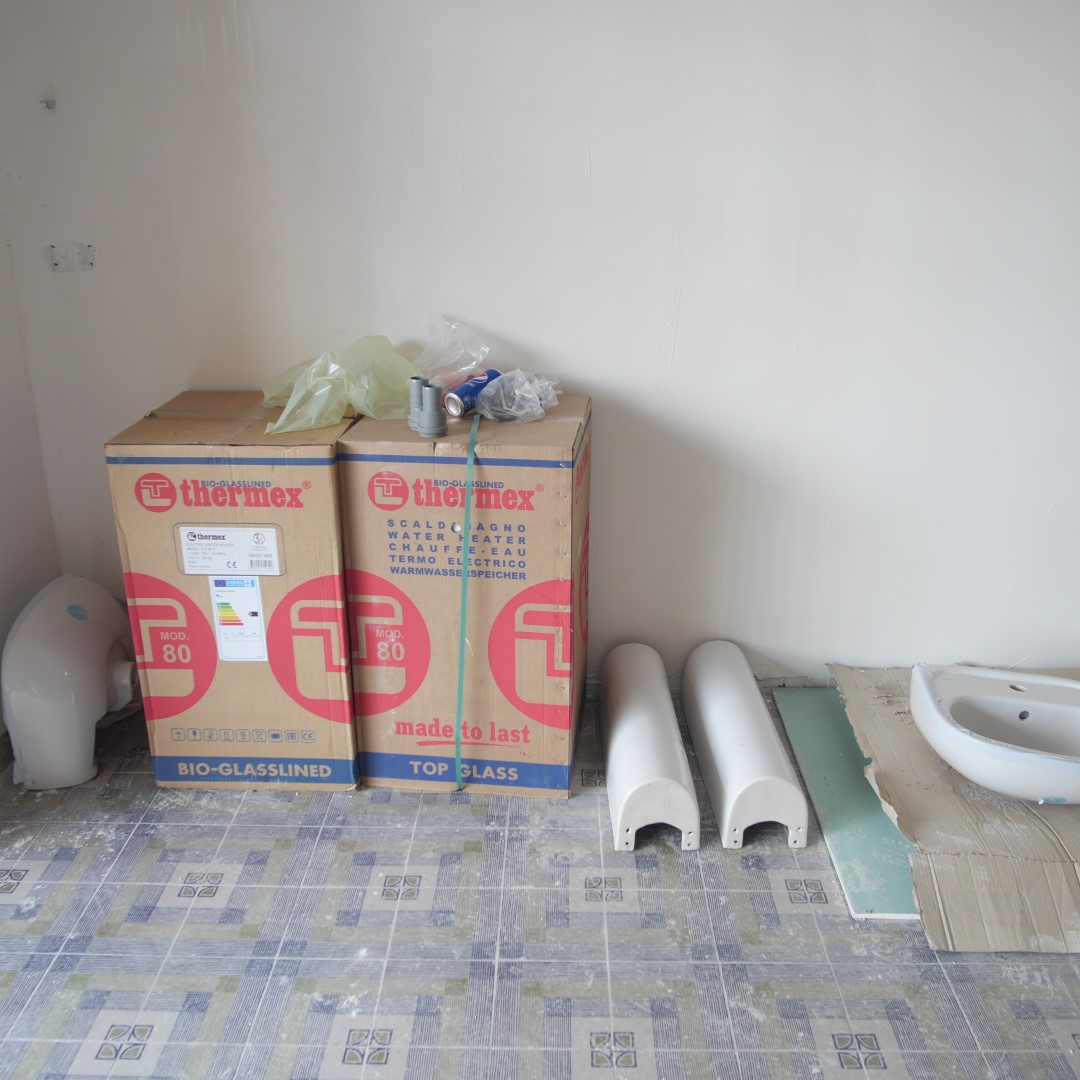

Thermex water heater - Made in Russia
One of the best brands for water heaters: Thermex. These are made in Russia - that's good enough for me.

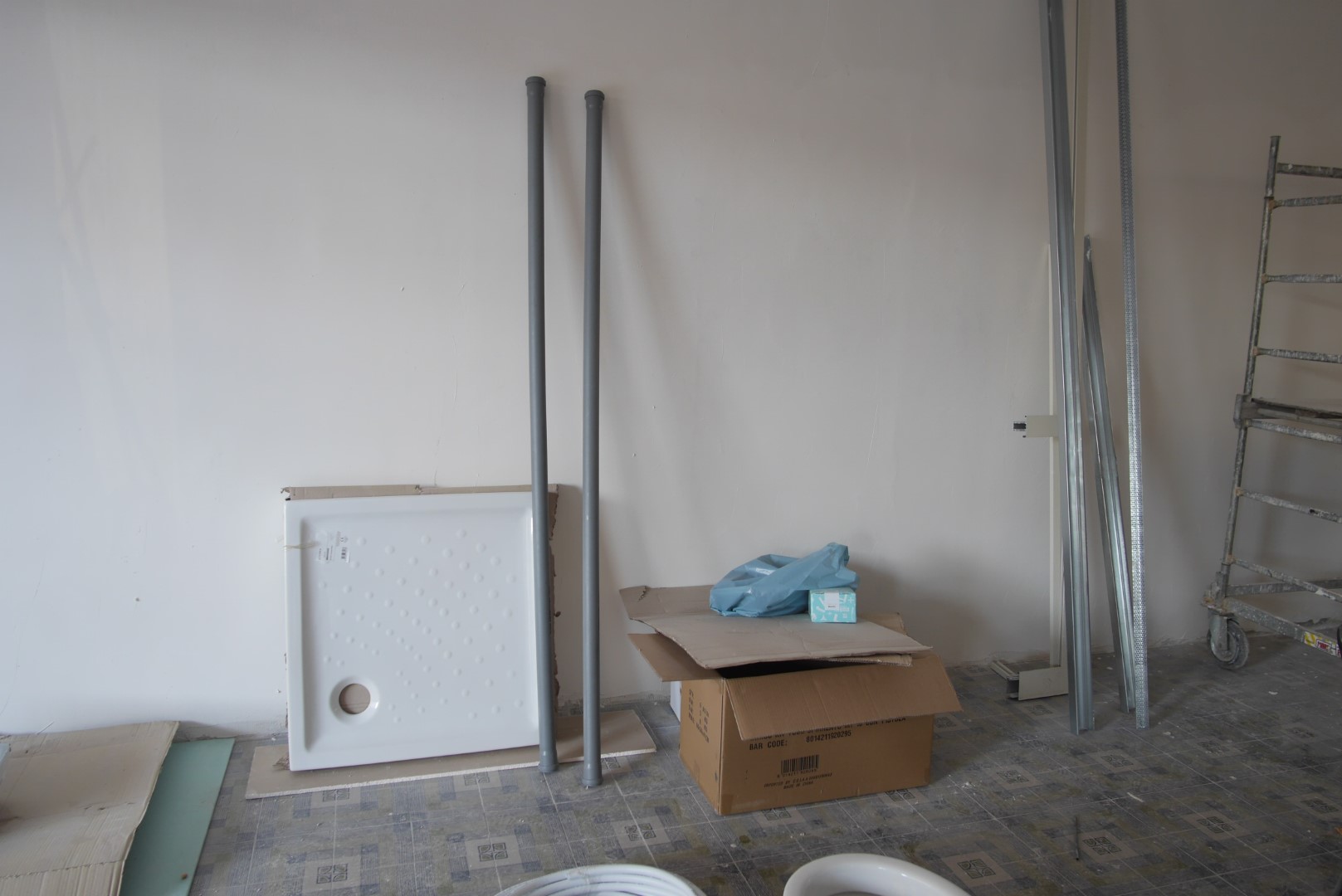

Shower plates and PVC pipes
Shower plates and PVC pipes

With most of the foundational work finished for the plumbing. Next week the plumber expects to put the finishing touch on the foundational work. Then the bricklayer and his crew should pour a mixture of concrete and sand over the plumbing foundation and raise the floors, painting will possibly begin, and tiling for the change rooms and bathrooms too should begin.

See the progress of Week Five
